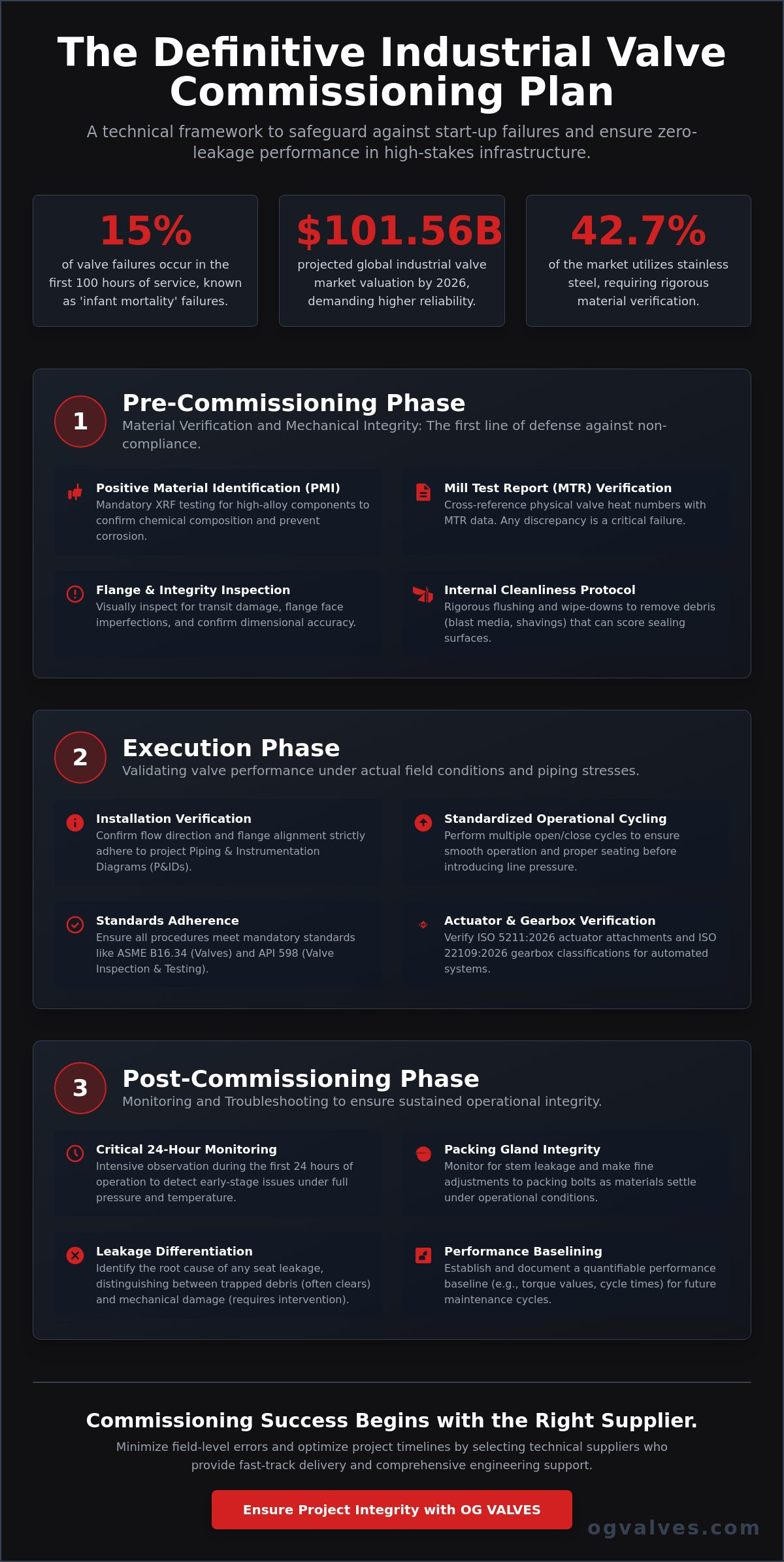

A single non-compliant valve can compromise an entire facility’s operational integrity, especially as the global industrial valve market expands toward a USD 101.56 billion valuation in 2026. Executing a rigorous industrial valve commissioning plan is the only technical safeguard against the catastrophic costs of start-up failure. You recognize that adherence to ASME and API standards is not a choice but a requirement for high-stakes infrastructure.
This technical guide delivers a comprehensive engineering framework designed to ensure zero-leakage performance and total regulatory compliance. It’s built to eliminate the delays often caused by improper material verification or the 25% tariff-related supply chain shifts seen in early 2026. We’ll analyze the essential protocols for verifying ISO 5211:2026 actuator attachments and ISO 22109:2026 gearbox classifications to guarantee that your system’s performance aligns with its design specifications. By following these clinical quality assurance protocols, engineers can mitigate the risks of quality fade and ensure that bulk orders meet the rigorous standards required for the oil, gas, and water treatment sectors.
An industrial valve commissioning plan serves as the definitive technical protocol for verifying that every valve assembly operates according to its original design intent. It isn’t merely a final inspection. It’s a rigorous engineering process that bridges the gap between mechanical completion and full-scale operation. The Fundamentals of Commissioning dictate that success depends on a structured transition where technical data meets field reality.
A primary role of this plan is the mitigation of ‘infant mortality’ failures. In high-pressure systems, approximately 15% of valve failures occur within the first 100 hours of service due to installation debris, misalignment, or improper torque. A robust commissioning framework identifies these vulnerabilities before they lead to unplanned downtime. This clinical approach ensures that the 2026 market standards for reliability are met without compromise.
Adherence to ASME B16.34 and API 598 standards is mandatory for all industrial valve commissioning plan executions. There’s a critical distinction between Factory Acceptance Testing (FAT) and site commissioning procedures. FAT confirms that a valve meets specifications in a controlled, manufacturer-led environment. In contrast, site commissioning validates performance under actual piping stresses, vibration, and thermal conditions present in the field.
The framework prioritizes absolute seat integrity. Achieving zero-leakage performance under operational pressure is the benchmark for industrial safety. Commissioning teams must focus on these specific goals:
This stage ensures that the 42.7% of the market utilizing stainless steel components maintains the integrity required for chemical processing.
Compliance requires mapping the plan to ISO 5208 for precise leakage rates and pressure testing. Detailed documentation is critical for environmental audits and safety inspections. In automated systems, Safety Instrumented Systems (SIS) play a vital role. They ensure that emergency shutdown valves (ESV) respond within the millisecond thresholds defined by the project’s safety integrity level (SIL) ratings. Without a logged commissioning report, a facility cannot demonstrate its adherence to international safety protocols during its first 24 hours of operation.
Mechanical completion isn’t synonymous with operational readiness. Within a professional industrial valve commissioning plan, the pre-installation phase serves as the primary filter for material non-compliance. While many field guides focus solely on final lubrication, our engineering standards demand a clinical verification of metallurgical integrity before a valve assembly ever meets the pipe. This phase ensures that the physical hardware matches the digital and paper specifications exactly.
The verification of Mill Test Reports (MTRs) against physical valve heat numbers is a binary requirement. There’s no room for ambiguity. Any discrepancy between the MTR data and the physical casting indicates a failure in the supply chain that must be addressed before the valve is positioned. Internal cleanliness is equally vital. Debris such as blast media, metal shavings, or construction dust can compromise seat integrity during the very first cycle. A rigorous flushing protocol or mechanical wipe-down of the internal bore is necessary to prevent permanent scoring of the sealing surfaces.
Utilizing handheld X-ray fluorescence (XRF) technology is mandatory for high-alloy components like Super Duplex or 316L stainless steel. This non-destructive testing confirms that the chemical composition aligns with the technical specifications of the project. Material verification is the first line of defense against stress corrosion cracking and localized pitting in corrosive environments. All PMI data must be logged and integrated into the final commissioning report to provide a complete traceability chain for the asset’s lifecycle. If you’re managing high-stakes infrastructure, you can review our technical specifications for specific material grades and testing protocols.
Protective end caps must remain in place until the moment of installation. For valves destined for oxygen or high-purity service, environmental controls are even more stringent; the ingress of microscopic particulate matter can result in catastrophic ignition or contamination. Integration of the actuator commissioning sequence should occur only after the mechanical integrity of the valve body and the condition of the stem are verified. Stems require specific lubrication and protection from atmospheric corrosion, especially during long-term site storage. Failure to maintain these barriers leads to packing leaks and operational resistance during the initial start-up phase.

Execution of the industrial valve commissioning plan demands a methodical progression from physical verification to functional validation. While generic guides often over-emphasize control valve signal tuning, a professional framework prioritizes the mechanical integrity of isolation components including gate, globe, and check valves. The first critical step involves installation verification. Engineers must confirm that flow direction arrows on the valve body align perfectly with the project P&IDs and that flange faces are parallel to prevent uneven gasket loading. Misalignment by even a few millimeters can lead to flange stress and premature seat failure once the system is pressurized.
Operational cycling follows under no-load conditions. This involves performing three to five full open and close strokes to ensure the assembly moves without obstruction. For check valves, this requires manual verification of the disc or clapper movement to ensure it isn’t seized or restricted by internal debris. Pressure testing is the ultimate validation of seat integrity. Adhering to API 598 or ISO 5208 standards, this stage involves low-pressure air tests (typically 60 to 100 psi) to detect minor gas leaks and high-pressure hydrostatic tests (1.1 times the maximum rated pressure) to confirm the mechanical strength of the shell and seat under load.
Final execution steps include synchronizing the actuator limit switches with the physical valve position. Documentation must record specific torque values and stroke times to provide a clinical data point for the asset’s initial state. For emergency shutdown valves, stroke times must be logged to the tenth of a second to ensure compliance with the safety integrity level (SIL) requirements of the facility.
High-performance butterfly valves often exhibit ‘stick-slip’ behavior if the seat-to-disc interface isn’t properly calibrated. Functional testing identifies these irregularities early. Manual overrides must also be engaged to verify that the valve can be operated during a total loss of power or pneumatic signal. This ensures that the mechanical drive train is robust enough to handle emergency manual intervention without stripping the gears or stem threads.
Calibration of pneumatic or electric actuators ensures 100% closure and prevents seat damage from over-torquing. Fail-safe positions, whether Fail Open (FO) or Fail Closed (FC), must be tested by simulating a total loss of air or electrical power. Every signal feedback loop must be verified against the Distributed Control System (DCS). This ensures that the control room receives accurate positional data within the required millisecond parameters, eliminating the risk of ‘ghost’ signals during critical plant start-up phases.
A successful industrial valve commissioning plan concludes with a transition into active monitoring. The initial 24-hour operational window is the most critical period for detecting latent mechanical discrepancies. During this time, engineers must differentiate between debris-related seat leakage and mechanical-related failures. Debris-related leakage often results from inadequate flushing during the pre-commissioning phase, leading to seat scoring. Conversely, mechanical leakage typically signals a failure in flange alignment or improper torque application during the execution phase. Clinical observation of these symptoms prevents minor issues from escalating into full system shutdowns.
Monitoring packing gland integrity is a primary requirement for environmental compliance. Thermal expansion during the first heat cycle can alter the compression of the packing material, necessitating precise adjustments. For valves in high-velocity steam or gas service, vibration analysis is mandatory. Excessive harmonics can lead to stem fatigue or actuator decouple events. If vibration levels exceed the thresholds defined in the project’s technical specifications, mechanical bracing or flow stabilization measures must be implemented immediately. To ensure your infrastructure meets these rigorous standards, you can consult with our technical engineering team regarding high-performance valve assemblies.
Acoustic emission testing provides a non-invasive method for verifying seat integrity under full operational pressure. This technology detects the high-frequency signals generated by fluid turbulence across a leaking seat, allowing for quantifiable data without breaking the pressure boundary. Troubleshooting check valves that fail to prevent backflow requires verifying the disc’s freedom of movement and the condition of the hinge pin. In many cases, backflow issues during startup are traced back to improper orientation or the presence of construction debris that restricts the disc’s travel. For live-loaded packing systems, adjustments must follow a calibrated torque sequence to maintain the seal without over-compressing the stem.
The final handover process involves compiling a comprehensive Valve Data Sheet (VDS) for every asset. This record must include hydro-test certificates, PMI reports, and the specific torque values recorded during the execution phase. As-built drawings are indispensable; they provide the definitive reference for the facility’s future Asset Integrity Management (AIM) programme. By establishing this baseline, operators can track performance degradation over time, ensuring that the 4.3% projected market growth in valve efficiency is realized through data-driven maintenance rather than reactive repairs. This documentation serves as the final validation of the asset’s operational integrity.
Procurement strategy functions as the final logistical pivot for an industrial valve commissioning plan. A failure at the supply chain level often manifests as a critical delay during the site-readiness phase. If a supplier provides inaccurate Mill Test Reports (MTRs) or fails to protect stem integrity during transit, the commissioning process cannot proceed. In 2026, where the global industrial valve market is valued up to USD 101.56 billion, procurement precision is a primary risk mitigation strategy. OG VALVES LTD. supplies high-specification gate valves and ball valves that arrive site-ready, ensuring that hardware meets design intent immediately upon delivery.
Lead time management becomes a critical variable during the final stages of plant construction. Project schedules are frequently compressed, leaving little margin for error in valve delivery. When procurement teams prioritize fast-track delivery from a technical partner rather than a commodity vendor, they eliminate the 15% to 20% delay factor typically caused by missing documentation or shipping damage. Global logistics expertise ensures that valves destined for remote oil and gas fields or water treatment facilities arrive with all required API and ASME certifications verified and attached to the assembly.
Technical supplier expertise serves as a secondary layer of quality control. Access to engineering specialists during the procurement phase allows for the resolution of complex specification queries before the valves are even manufactured. This proactive approach reduces field-level errors by ensuring that the industrial valve commissioning plan is supported by hardware that is purpose-built for the intended service environment, whether it involves cryogenic temperatures or high-pressure steam. Every valve must be viewed as a critical asset in a larger infrastructure network rather than a standalone component.
Reducing project downtime requires strategic stockholding of high-specification components. By maintaining inventory of forged steel and alloy valves, suppliers can support narrow commissioning windows that would otherwise be missed due to standard manufacturing lead times. Managing complex logistics for international industrial sites involves navigating the 25% tariff adjustments seen in early 2026 and ensuring that “quality fade” does not occur during bulk transit. Every valve must be ‘commissioning-ready’ upon arrival, with end caps intact and lubrication applied to the manufacturer’s specification.
Comprehensive material certification is the only technical safeguard for passing regulatory audits during the handover phase. Engineers need absolute certainty that the valves in their system meet the chemical and mechanical properties required by ISO and ANSI standards. OG VALVES LTD. provides a complete data package with every order, including hydrostatic test certificates and PMI reports. This level of transparency positions the supplier as a technical partner in heavy industry infrastructure, facilitating a seamless transition from the planning phase to full operational status.
Operational integrity is the result of methodical engineering, not chance. Successful plant start-ups require a rigorous industrial valve commissioning plan that prioritizes metallurgical traceability and clinical execution. By verifying material integrity through PMI and adhering to the pressure testing standards established during the execution phase, engineers eliminate the vulnerabilities that compromise high-pressure systems. The transition from mechanical completion to full operation is secured only when field documentation matches design specifications exactly.
